How a Data Center Is Built: The 12 Phases From Raw Land to Energized Racks
A data center is built in twelve phases: site selection and control, power interconnection, entitlements and permits, design, long-lead procurement, sitework, shell and core, MEP fit-out, five levels of commissioning, utility energization, IT installation and operations. The building itself takes 18 to 30 months. The schedule, however, is set by power: the average wait for a grid connection in primary US markets now exceeds four years, and a large power transformer takes about 128 weeks to arrive. This guide walks through every phase, who owns it, what it costs and where it goes wrong in 2026.

Read as text

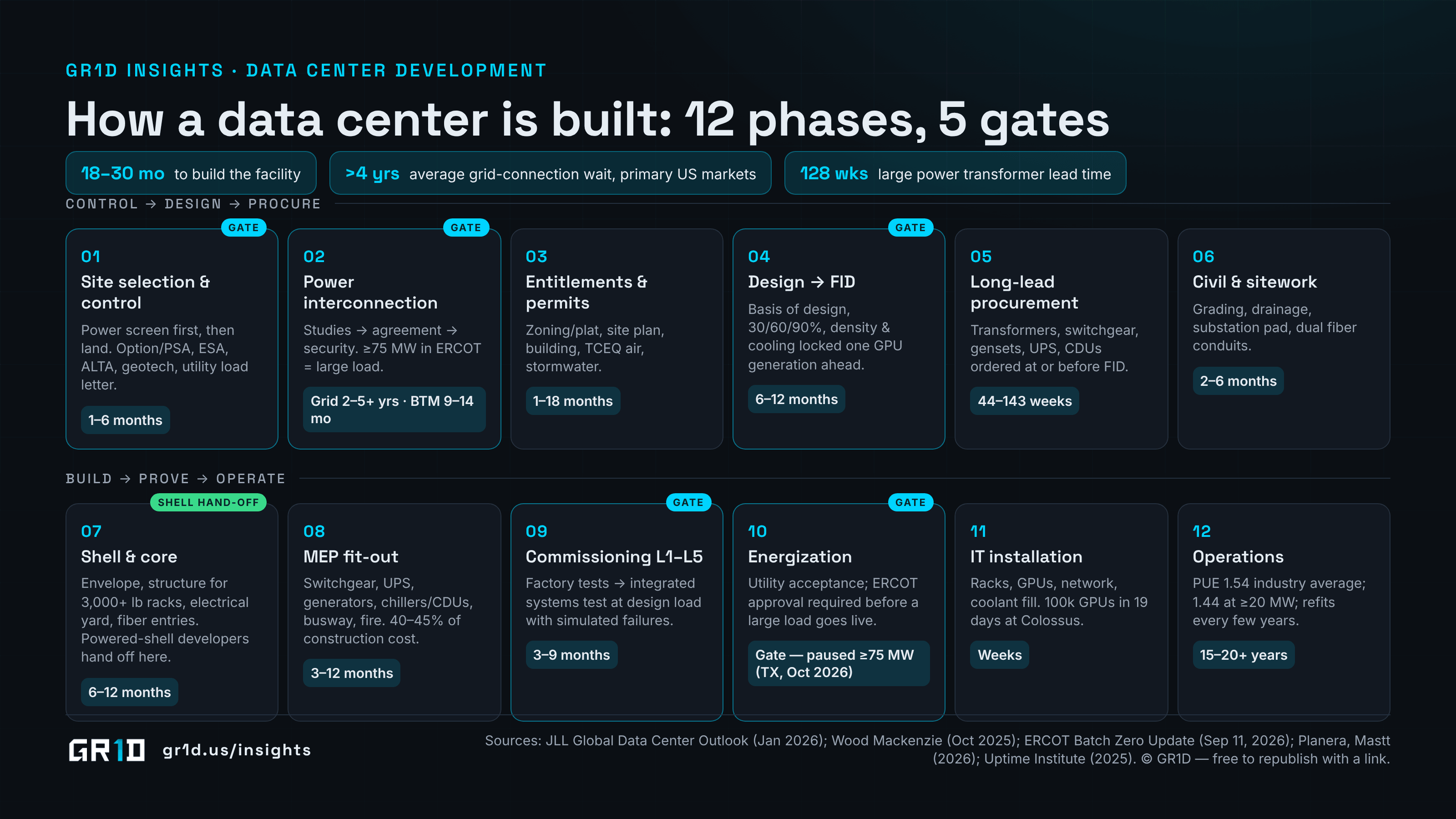

- How a data center is built: 12 phases, 5 gates
- 18–30 mo to build the facility
- >4 yrs average grid-connection wait, primary US markets
- 128 wks large power transformer lead time
- CONTROL → DESIGN → PROCURE
- 01 · Site selection & control · Power screen first, then land. Option/PSA, ESA, ALTA, geotech, utility load letter. · 1–6 months
- 02 · Power interconnection · Studies → agreement → security. ≥75 MW in ERCOT = large load. · Grid 2–5+ yrs · BTM 9–14 mo
- 03 · Entitlements & permits · Zoning/plat, site plan, building, TCEQ air, stormwater. · 1–18 months
- 04 · Design → FID · Basis of design, 30/60/90%, density & cooling locked one GPU generation ahead. · 6–12 months
- 05 · Long-lead procurement · Transformers, switchgear, gensets, UPS, CDUs ordered at or before FID. · 44–143 weeks
- 06 · Civil & sitework · Grading, drainage, substation pad, dual fiber conduits. · 2–6 months
- BUILD → PROVE → OPERATE
- 07 · Shell & core · Envelope, structure for 3,000+ lb racks, electrical yard, fiber entries. Powered-shell developers hand off here. · 6–12 months
- 08 · MEP fit-out · Switchgear, UPS, generators, chillers/CDUs, busway, fire. 40–45% of construction cost. · 3–12 months
- 09 · Commissioning L1–L5 · Factory tests → integrated systems test at design load with simulated failures. · 3–9 months
- 10 · Energization · Utility acceptance; ERCOT approval required before a large load goes live. · Gate — paused ≥75 MW (TX, Oct 2026)
- 11 · IT installation · Racks, GPUs, network, coolant fill. 100k GPUs in 19 days at Colossus. · Weeks
- 12 · Operations · PUE 1.54 industry average; 1.44 at ≥20 MW; refits every few years. · 15–20+ years
What "building a data center" actually means in 2026
The phrase covers four different products, and most confusion about timelines and costs comes from mixing them up. Powered land is a site with entitlements and a credible path to utility power; it traded at about $584,000 per MW in primary US markets this year, up 51% year over year (Cushman & Wakefield, Sep 2026). A powered shell adds the building envelope, the utility feeds and fiber entries, and hands the mechanical and electrical fit-out to the tenant. Turnkey delivers the finished facility with switchgear, UPS, generators and cooling commissioned. Colocation sells slices of a turnkey building by the rack or the kilowatt.
The twelve phases below apply to all four; what changes is where the developer stops and the tenant starts. GR1D builds powered shells and turnkey facilities, so this guide covers the full sequence and marks the hand-off point.
Phase 1 — Site selection and control (1–6 months)
Everything starts with a power screen, not a land search. Developers map substations, transmission corridors and distribution headroom first, then fiber routes, water and floodplain, and only then look at parcels. JLL's 2026 outlook reports that "speed to power" has overtaken location and cost as the number-one site criterion (JLL, Jan 2026).
Control comes through an option or purchase agreement, with due diligence running in parallel: a Phase I environmental assessment, an ALTA survey, a geotechnical report and — the piece that matters most — a utility load letter or will-serve response. Published guides put this phase at three to six months (Planera, Sep 2026); it runs longer when the utility answer is slow, which in 2026 is most of the time.
Gate 1: site control plus a written utility response. Without both, nothing else is financeable.
Phase 2 — Power interconnection (the phase that sets the date)
Grid interconnection is a study process, not a purchase. The sequence is application, screening, feasibility study, system impact study, facilities study, interconnection agreement, utility construction and energization (RMI, Apr 2026). Each study has a queue in front of it.
The numbers are now well documented. Average time to a grid connection in primary US markets exceeds four years (JLL, Jan 2026); CBRE reports waits above ten years in some constrained markets (CBRE, mid-2026). A dedicated substation and interconnect, once approved, is an 18-to-24-month build of its own (Giatec, Apr 2026).
In ERCOT the process has a hard threshold. Loads of 75 MW or more are "large loads" under Texas Senate Bill 6: a $100,000 screening-study fee, disclosure of on-site backup, curtailment obligations for loads interconnecting after December 31, 2025, and a 120-day ERCOT study for co-located generation (Bracewell, 2025). The PUCT's rule adopted September 18, 2026 adds financial security of $50,000 per MW before study, refunded in tranches after energization (White & Case, Sep 2026). ERCOT's queue stood near 474 GW in August 2026 — roughly five times the system's record peak — and about 90% of it is data centers (POWER/BNEF, Aug 2026).
Sites below the 75 MW line, sites on existing substations with headroom, and sites with behind-the-meter generation avoid most of the Batch Zero queue. That is the premise behind smaller, bespoke builds, which we cover in How Data Centers Are Powered.
Gate 2: a signed interconnection or energy supply agreement with posted security. Letters of intent and queue positions will not secure construction debt.
Phase 3 — Entitlements and permits (1–18 months)
The permit stack is zoning or platting, site plan approval, building permits, air permits for generators and stormwater coverage. Published ranges run from six to eighteen months (Mastt, Feb 2026; Avisen, Apr 2026), but Texas is structurally faster in normal times. Counties cannot zone, so most rural sites face no zoning hearing at all; zoning authority sits with cities under Local Government Code chapter 211 (Compute Law Blog, Sep 2026), and nearly half of planned Texas data centers are in unincorporated areas (Texas Tribune, Jun 2026).
Air permitting is the long pole. TCEQ's permit-by-rule for emergency engines up to 3.2 MW carries a 45-day review and an 876-hour annual operating cap; a minor New Source Review permit for larger on-site generation averaged around 240 days of processing, and a major permit up to 365 (TCEQ, Apr 2026). As noted above, TCEQ issuance is paused for data centers as of September 21, 2026.
Community opposition is now a schedule input in its own right: Data Center Watch counted 75 projects worth $130 billion blocked or delayed in the first quarter of 2026 alone (Fortune, Jun 2026).
Phase 4 — Design (6–12 months)
Design runs from concept through 30%, 60% and 90% documents to construction drawings, anchored by a Basis of Design that fixes the numbers everything else depends on: IT load, rack density, redundancy topology (N+1 or 2N), cooling approach (air, direct-to-chip liquid or both), floor loading and phasing. Six to twelve months is typical (Mastt; Planera); campuses with multiple buildings run longer.
The hard part in 2026 is designing for a chip that does not exist yet. Rack power has roughly doubled with each annual NVIDIA generation — about 25 kW for A100-class racks in 2022, 40 kW for H100, 132 kW for GB200 NVL72 and a projected 240 kW for Vera Rubin (Schneider Electric, Jul 2025). Design teams now plan structure, busway and liquid loops one to two generations ahead.
Gate 3: final investment decision. Mastt's development guide is blunt about it: do not start site work until every FID criterion — power agreement, permits, financing, contractor pricing — is complete (Mastt, Nov 2025).
Phase 5 — Long-lead procurement (ordered before you break ground)
This phase overlaps design and often precedes permits, because the equipment calendar is longer than the construction calendar.

Read as text

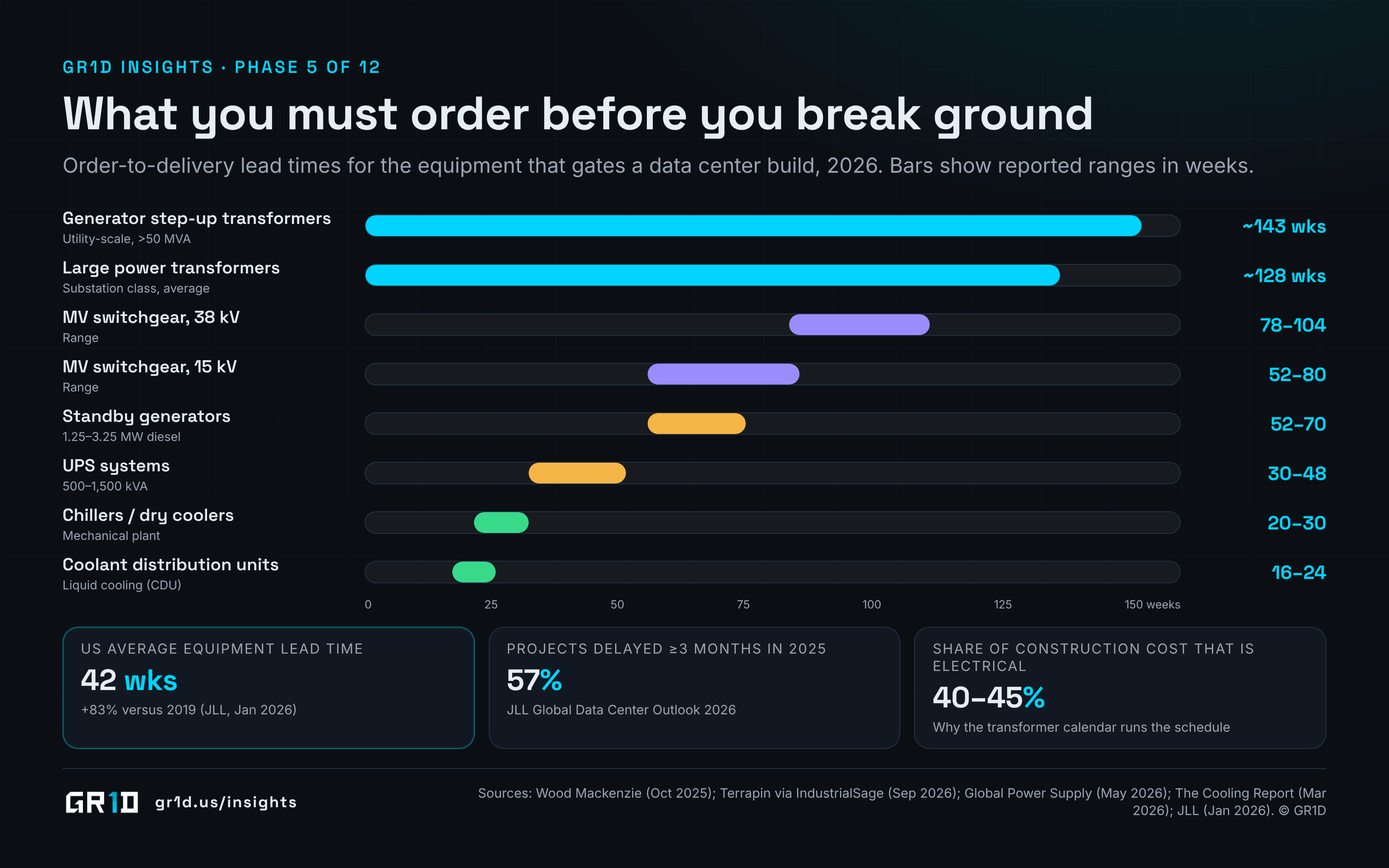

- What you must order before you break ground
- Order-to-delivery lead times for the equipment that gates a data center build, 2026. Bars show reported ranges in weeks.
- Generator step-up transformers · Utility-scale, >50 MVA
- Utility-scale, >50 MVA
- ~143 wks
- Large power transformers · Substation class, average
- Substation class, average
- ~128 wks
- MV switchgear, 38 kV · Range
- Range
- 78–104
- MV switchgear, 15 kV · Range
- 52–80
- Standby generators · 1.25–3.25 MW diesel
- 1.25–3.25 MW diesel
- 52–70
- UPS systems · 500–1,500 kVA
- 500–1,500 kVA
- 30–48
- Chillers / dry coolers · Mechanical plant
- Mechanical plant
- 20–30
- Coolant distribution units · Liquid cooling (CDU)
- Liquid cooling (CDU)
- 16–24
- 0 · 25 · 50 · 75 · 100 · 125 · 150 weeks
- 25
- 50
- 75
- 100
- 125
- 150 weeks
- US AVERAGE EQUIPMENT LEAD TIME · 42 wks · +83% versus 2019 (JLL, Jan 2026)
- PROJECTS DELAYED ≥3 MONTHS IN 2025 · 57% · JLL Global Data Center Outlook 2026
- SHARE OF CONSTRUCTION COST THAT IS ELECTRICAL · 40–45% · Why the transformer calendar runs the schedule
| Equipment | 2026 lead time | Source |
|---|---|---|
| Large power transformers | ~128 weeks average | Wood Mackenzie, Oct 2025 |
| Generator step-up transformers | ~143 weeks | Wood Mackenzie, Oct 2025 |
| Medium-voltage switchgear, 38 kV / 15 kV | 78–104 weeks / 52–80 weeks | Terrapin via IndustrialSage, Sep 2026 |
| Standby generators, 1.25–3.25 MW | 52–70 weeks | Global Power Supply, May 2026 |
| UPS, 500–1,500 kVA | 30–48 weeks | Terrapin via IndustrialSage, Sep 2026 |
| Chillers / dry coolers | 20–30 weeks | The Cooling Report, Mar 2026 |
| Coolant distribution units (CDUs) | 16–24 weeks | The Cooling Report, Mar 2026 |
The system-level number is just as telling: average US equipment lead time is 42 weeks, 83% longer than in 2019, and 57% of data center projects slipped by three months or more in 2025 (JLL, Jan 2026). Experienced developers place transformer and switchgear orders at or before FID and carry the deposits as a cost of speed.
Phase 6 — Civil and sitework (2–6 months)
Grading, drainage, utility trenching, the substation pad and stormwater controls. Two to four months on a flat, dry site (Planera); longer where rock, wetlands or a long utility run intervene. This is also when the fiber conduits go in: two diverse entries is the minimum tenants expect.
Phase 7 — Shell and core (6–12 months)
Foundations, structure (tilt-wall, precast or steel), roof, envelope and the electrical yard. A powered shell on its own takes six to twelve months once sitework is done (LandGate, Jan 2026). Shells built for AI tenants are heavier than their predecessors: a single GB200 NVL72 rack weighs 3,245 lb before coolant, piping and distribution units are added (HPE QuickSpecs, Sep 2026), which pushes developers toward slab-on-grade designs rated well above legacy raised-floor limits.
This is the powered-shell hand-off. The developer delivers the envelope, the utility feeds and the fiber points of entry; the tenant installs UPS, generators and cooling (LandGate). Well-drafted shell leases spell out who commissions what, latent-defect periods, warranties and acceptance tests (Build.inc, May 2026). Shell pricing in 2026 is roughly $105–275 per gross square foot, about 10–20% of a finished facility's cost (DgtlInfra).
Phase 8 — MEP fit-out (3–12 months)
Switchgear, UPS, generators, chillers or coolant distribution units, busway, fire suppression and controls. Six to twelve months for a full building (Planera); three to six for a tenant finishing a delivered shell (DgtlInfra). Electrical work is 40–45% of total construction cost, which is why the transformer and switchgear calendar in Phase 5 dominates the schedule here.
For AI halls, the fit-out now includes the liquid loop: coolant distribution units, manifolds and secondary piping sized for racks where roughly 90% of heat is rejected to water and only about 14 kW per rack is left for air (JLL via DCD, Oct 2026).
Phase 9 — Commissioning, Levels 1 through 5 (3–9 months)
Commissioning is the phase operators cut when schedules slip and the phase that causes outages when it is cut. Uptime Institute's 2025 survey attributes 45% of impactful outages to power, with UPS failures the largest single cause (Uptime Institute, 2025). The five levels are standard across the industry (Anvilfield, Jun 2026):

Read as text

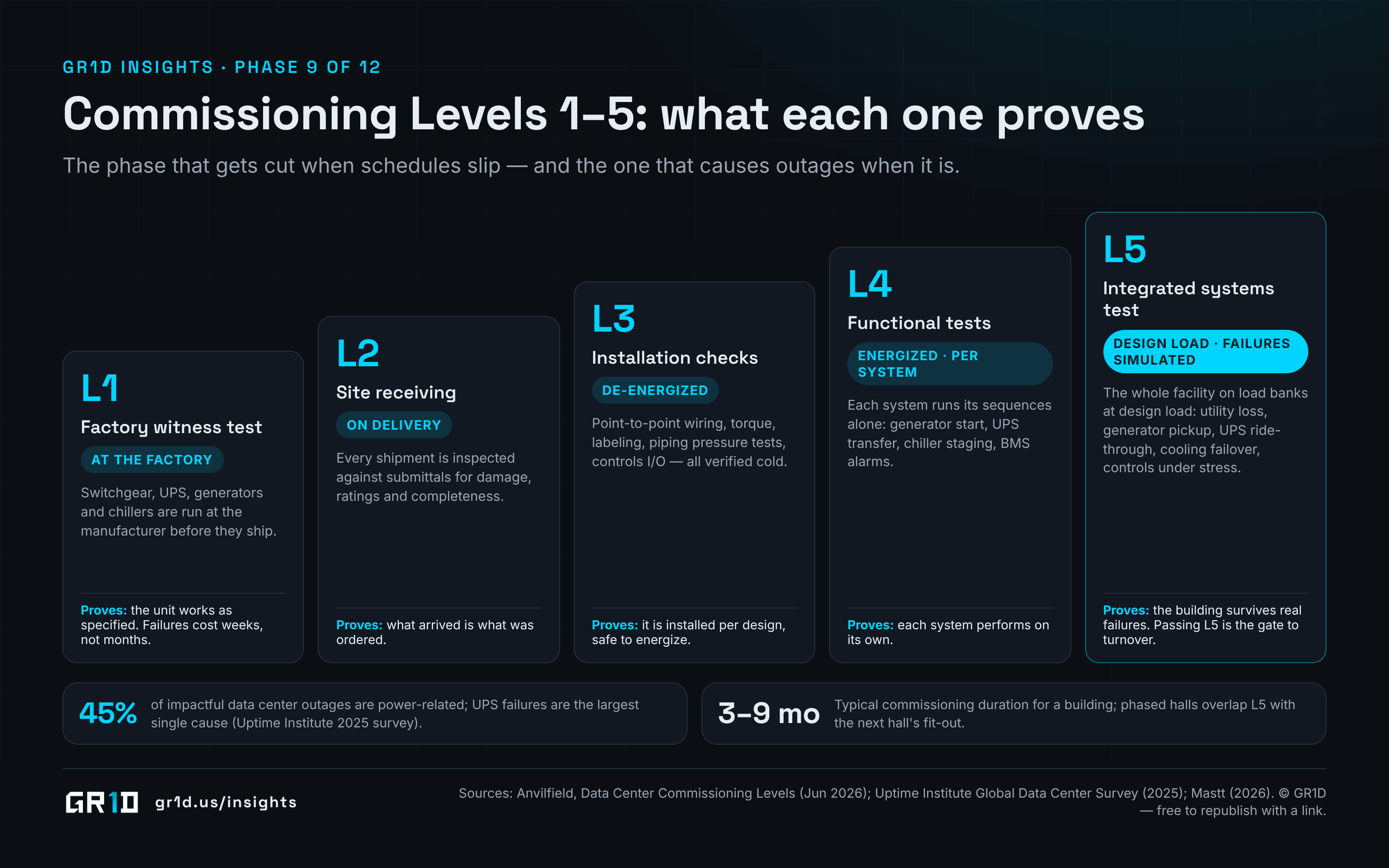

- Commissioning Levels 1–5: what each one proves
- The phase that gets cut when schedules slip — and the one that causes outages when it is.
- L1
- Factory witness test
- AT THE FACTORY
- Switchgear, UPS, generators and chillers are run at the manufacturer before they ship.
- Proves: the unit works as specified. Failures cost weeks, not months.
- Proves:
- L2
- Site receiving
- ON DELIVERY
- Every shipment is inspected against submittals for damage, ratings and completeness.
- Proves: what arrived is what was ordered.
- L3
- Installation checks
- DE-ENERGIZED
- Point-to-point wiring, torque, labeling, piping pressure tests, controls I/O — all verified cold.
- Proves: it is installed per design, safe to energize.
- L4
- Functional tests
- ENERGIZED · PER SYSTEM
- Each system runs its sequences alone: generator start, UPS transfer, chiller staging, BMS alarms.
- Proves: each system performs on its own.
- L5
- Integrated systems test
- DESIGN LOAD · FAILURES SIMULATED
- The whole facility on load banks at design load: utility loss, generator pickup, UPS ride-through, cooling failover, controls under stress.
- Proves: the building survives real failures. Passing L5 is the gate to turnover.
- 45% · of impactful data center outages are power-related; UPS failures are the largest single cause (Uptime Institute 2025 survey).
- 3–9 mo · Typical commissioning duration for a building; phased halls overlap L5 with the next hall's fit-out.
- Level 1 — factory witness tests. Major equipment is tested at the manufacturer before shipment; failures here cost weeks, not months.
- Level 2 — site receiving. Each delivery is inspected against the submittals.
- Level 3 — installation checks. De-energized verification that everything is installed and wired per design.
- Level 4 — functional tests. Each system is energized and run through its sequences individually.
- Level 5 — integrated systems test. The whole facility runs at design load on load banks while failures are simulated: utility loss, generator start, UPS ride-through, cooling failover. Passing Level 5 is the gate to turnover.
Three to six months is typical for a single building (Mastt); phased halls can overlap commissioning with fit-out of the next hall.
Gate 4: Level 5 passed and turnover documents issued.
Phase 10 — Energization and utility acceptance
The utility energizes the service and, in ERCOT, approves the load. ERCOT requires an energization request to be approved before a new large load comes online (ERCOT); as of August 2026 that approval is paused for computational loads of 75 MW and above, with 17 loads totalling 6.6 GW having cleared stability studies but still awaiting approval (Utility Dive, Aug 21, 2026).
Gate 5: energization approval. This is the gate the market under-plans for, and the reason time-to-power — not time-to-build — is the number that matters.
Phase 11 — IT installation (weeks to months)
Racks, GPUs, networking, coolant fill and burn-in. On a prepared facility this is fast: xAI's Colossus installed 100,000 GPUs in 19 days after a 122-day infrastructure build in an existing factory (Data Center Frontier, Nov 2024), and Stargate Abilene had OpenAI workloads running less than a year after groundbreaking (Oracle fact sheet, Sep 2025). Each GB200 NVL72 rack needs 192 kW of busway provisioned even though it draws 132 kW nominally (HPE) — a detail that has to be in the Phase 4 design, not discovered here.
Phase 12 — Operations
A facility built this way runs for fifteen to twenty years or more and is re-fitted for new hardware every few. The operating metric that follows it everywhere is PUE: the industry average has been stuck around 1.54 for six years, facilities of 20 MW and above average 1.44, and Google's fleet reports 1.09 (Uptime Institute, 2025; Google, 2025).
How long does the whole thing take?
Add the phases serially and you get three to six years; overlap them the way experienced teams do and the building takes 18 to 30 months while power runs in parallel. JLL puts the average build of a 50 MW facility at 18 months (JLL, Jan 2026). Whether the project finishes in two years or six depends almost entirely on Phase 2. We break the schedule down with best-case, typical and slipped scenarios in Realistic Data Center Timelines in 2026.
What does it cost, by stage?
| Delivery stage | 2026 cost signal | Source |
|---|---|---|
| Powered land | ~$584,000 per MW (primary US markets, +51% YoY) | Cushman & Wakefield, Sep 2026 |
| Powered shell | $105–275 per gross sq ft; ~10–20% of a finished facility | DgtlInfra |
| Shell and core, 50 MW air-cooled | ~$11.3M per MW (2026 forecast); liquid cooling +10%, multistory +20% | JLL, Jan 2026 |
| High-density turnkey | $14–16M per MW | CBRE, mid-2026 |
| Modern greenfield, all-in (excluding GPUs) | ~$17.6M per MW, +21% since Q4 2024; power infrastructure ≈ 21% of cost | Cushman & Wakefield, Sep 2026 |
| AI tenant fit-out | up to $25M per MW on top of the shell | JLL, Jan 2026 |
How is an AI data center built differently?
The sequence is the same; four things inside it change. Density: AI training halls need roughly ten times the power density of traditional space and command about a 60% lease premium (JLL, Jan 2026), while the industry's modal rack is still about 9 kW and more than 80% of facilities have nothing above 30 kW (Uptime Institute, 2025). Cooling: JLL expects up to 70% of AI facilities to be liquid-cooled by 2027. Power delivery: 192 kW busway per rack today and NVIDIA's 800 VDC architecture targeting 1 MW racks from 2027. Structure: 3,000-plus-pound racks, flooded CDUs approaching three tons, and slab designs to match. The cost premium for all of this is 7–10% in the US, with 5.5% construction inflation in 2025 on top (Turner & Townsend, Nov 2025).
Frequently asked questions
How long does it take to build a data center?
The building takes 18 to 30 months; JLL's 2026 average for a 50 MW facility is 18 months. End to end, including site control, permits and power, plan on three to six years in primary markets, because grid connection waits now exceed four years. Sites with existing substation capacity or on-site generation can energize in nine to fourteen months.
What are the phases of data center construction?
Site selection and control, power interconnection, entitlements and permits, design, long-lead procurement, sitework, shell and core, MEP fit-out, commissioning Levels 1–5, energization, IT installation and operations. Five gates control the sequence: site control, a signed power agreement, FID, Level 5 commissioning and energization approval.
What is a powered shell data center?
A building delivered with the envelope, utility power feeds, substation or switchyard and fiber entries in place, but without the UPS, generators and cooling plant. The tenant installs those. It typically costs $105–275 per gross square foot and takes six to twelve months to build once sitework is done.
How much does it cost to build a data center per MW?
In 2026, roughly $11.3M per MW for shell and core (JLL), $14–16M per MW for high-density turnkey (CBRE), and $17.6M per MW all-in excluding GPUs (Cushman & Wakefield). AI tenant fit-out can add up to $25M per MW. Powered land alone averages about $584,000 per MW in primary markets.
Why does power take longer than construction?
Because interconnection is a utility study process with queues at each step, and the key equipment — large power transformers at about 128 weeks — is back-ordered industry-wide. In ERCOT, loads of 75 MW or more also go through the Batch Zero process, which is paused for computational loads as of August 2026.
What is Batch Zero in ERCOT?
ERCOT's batch study for large loads (75 MW and above) seeking interconnection. Provisional classification in September 2026 sorted 204 base-load projects (66.4 GW) and 158 studied projects (127.9 GW), with 373 projects excluded. ERCOT has said the study will not finish by April 9, 2027.
Sources
- 2026 Global Data Center Outlook — JLL, 2026-01-08
- Global data center sector to nearly double to 200 GW — JLL, 2026-01-06
- 2026 Data Center Development Cost Guide — Cushman & Wakefield, 2026-09-03
- US Real Estate Market Outlook Midyear Review: Data Centers — CBRE, 2026
- Mind the gap: tackling supply chain challenges in the electric T&D sector — Wood Mackenzie, 2025-10-15
- Switchgear lead times 2026 — IndustrialSage (Terrapin data), 2026-09-01
- Generator lead times in 2026 — Global Power Supply, 2026-05-11
- Data center cooling supply chain guide 2026 — The Cooling Report, 2026-03-31
- Uptime Institute Global Data Center Survey 2025 — Uptime Institute, 2025
- HPE NVIDIA GB200 NVL72 QuickSpecs — HPE, 2026-09-08
- Batch Zero Update — ERCOT, 2026-09-11
- Large Load Integration — ERCOT, 2026
- Texas Large Load Interconnection Update: ERCOT Batch Zero Pause and Verification Process — Baker Botts, 2026-08
- Texas PUC approves data center audit — Utility Dive, 2026-08-21
- Texas audit could delay 49.8 GW of data center load — POWER, 2026-08-06
- PUCT sets financial commitments for data center interconnection; Governor pauses permits — White & Case, 2026-09-25
- Texas pauses all environmental permitting for data centers — Beveridge & Diamond, 2026-09-29
- Texas Senate Bill 6 ushers in major overhaul of large load interconnection — Bracewell, 2025
- Air permitting for data centers (AAPCA presentation) — TCEQ Air Permits Division, 2026-04-07
- Texas zoning and land use for AI data centers — Compute Law Blog, 2026-09-28
- Texas data centers and local control — Texas Tribune, 2026-06-02
- Data center opposition blocked or delayed $130B of projects — Fortune, 2026-06-16
- Understanding large load interconnection — RMI, 2026-04-14
- Data Center Construction: Costs, Timeline, and Delivery Steps — Mastt, 2026-02-20
- Data Center Development guide — Mastt, 2025-11-18
- Data Center Construction Guide: 10 Phases — Planera, 2026-09-30
- How long does it take to develop a data center? — Avisen Legal, 2026-04-20
- Data Center Construction Guide for GCs — Giatec, 2026-04-10
- Powered shell data centers: everything you need to know — LandGate, 2026-01-10
- Powered shell data centers — DgtlInfra, 2024-04-20
- Building a Data Center: An In-Depth Guide — DgtlInfra, 2026-03-26
- Powered shell data centers — Build.inc, 2026-05-09
- Data center commissioning levels and process — Anvilfield, 2026-06-27
- AI data center design and deployment are moving at an incredible pace — Schneider Electric, 2025-07-23
- The density gap in data center real estate — DCD / JLL, 2026-10-08
- The Colossus AI supercomputer — Data Center Frontier, 2024-11-20
- Oracle / OpenAI Abilene data center fact sheet — Oracle, 2025-09-22
- Data center efficiency (PUE) — Google, 2025
- AI data centre rush raises alarm over construction supply chain — Turner & Townsend, 2025-11-05
Building or financing an AI data center in Texas?
GR1D develops powered-shell and turnkey AI data centers — 20 MW to 150 MW sites with power, fiber and entitlements solved before the first rack arrives. See how we build, browse our sites or talk to us.
