DesignOct 15, 202611 min readBy Jamieson Hill

800 VDC and Vera Rubin: How NVIDIA's Next Platform Rewrites Data Center Electrical Design

An 800 VDC data center converts utility AC to 800 volts DC once, at the row or the facility, and distributes DC to racks that step it straight down to GPU voltages. NVIDIA is driving the change because a 1 MW rack on 54 V busbars would need about 200 kg of copper and 64 U of power shelves. Sidecar hardware ships in 2026, native 800 VDC buildings follow in 2027–2029, and most of what they need is poured, hung or trenched when the shell is built.

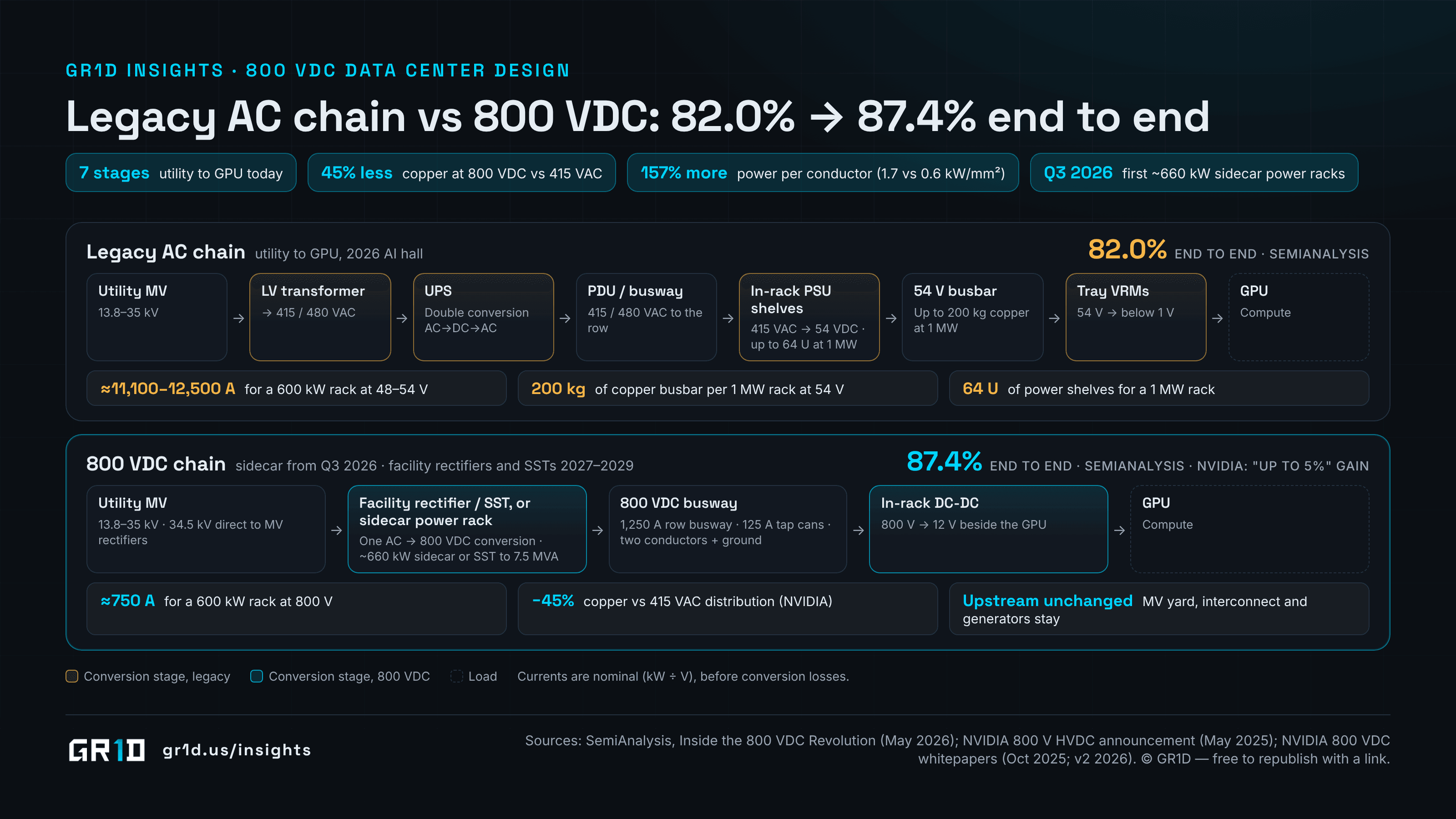

Two power chains side by side: the legacy AC chain from utility medium voltage through a low-voltage transformer, UPS, PDU and busway, in-rack 415 VAC to 54 VDC power shelves, 54 V busbar and tray VRMs at 82.0% end-to-end efficiency, versus the 800 VDC chain from medium voltage through a facility rectifier or sidecar power rack, 800 VDC busway and in-rack DC-DC conversion at 87.4%, with 45% less copper and about 750 A instead of 11,100 to 12,500 A for a 600 kW rack.
The legacy AC power chain versus the 800 VDC chain, end to end. Sources: SemiAnalysis May 2026; NVIDIA May 2025, Oct 2025 and 2026 whitepapers. © GR1D — free to republish with a link to this article.Full size ↗
Read as text
  • Legacy AC chain vs 800 VDC: 82.0% → 87.4% end to end
  • 7 stages utility to GPU today
  • 45% less copper at 800 VDC vs 415 VAC
  • 157% more power per conductor (1.7 vs 0.6 kW/mm²)
  • Q3 2026 first ~660 kW sidecar power racks
  • Legacy AC chainutility to GPU, 2026 AI hall
  • utility to GPU, 2026 AI hall
  • 82.0%END TO END · SEMIANALYSIS
  • END TO END · SEMIANALYSIS
  • Utility MV
  • 13.8–35 kV
  • LV transformer
  • → 415 / 480 VAC
  • UPS
  • Double conversion AC→DC→AC
  • PDU / busway
  • 415 / 480 VAC to the row
  • In-rack PSU shelves
  • 415 VAC → 54 VDC · up to 64 U at 1 MW
  • 54 V busbar
  • Up to 200 kg copper at 1 MW
  • Tray VRMs
  • 54 V → below 1 V
  • GPU
  • Compute
  • ≈11,100–12,500 A for a 600 kW rack at 48–54 V
  • ≈11,100–12,500 A
  • 200 kg of copper busbar per 1 MW rack at 54 V
  • 200 kg
  • 64 U of power shelves for a 1 MW rack
  • 64 U
  • 800 VDC chainsidecar from Q3 2026 · facility rectifiers and SSTs 2027–2029
  • sidecar from Q3 2026 · facility rectifiers and SSTs 2027–2029
  • 87.4%END TO END · SEMIANALYSIS · NVIDIA: "UP TO 5%" GAIN
  • END TO END · SEMIANALYSIS · NVIDIA: "UP TO 5%" GAIN
  • 13.8–35 kV · 34.5 kV direct to MV rectifiers
  • Facility rectifier / SST, or sidecar power rack
  • One AC → 800 VDC conversion · ~660 kW sidecar or SST to 7.5 MVA
  • 800 VDC busway
  • 1,250 A row busway · 125 A tap cans · two conductors + ground
  • In-rack DC-DC
  • 800 V → 12 V beside the GPU
  • ≈750 A for a 600 kW rack at 800 V
  • ≈750 A
  • −45% copper vs 415 VAC distribution (NVIDIA)
  • −45%
  • Upstream unchanged MV yard, interconnect and generators stay
  • Upstream unchanged
  • Conversion stage, legacy · Conversion stage, 800 VDC · Load · Currents are nominal (kW ÷ V), before conversion losses.
  • Conversion stage, legacy
  • Conversion stage, 800 VDC
  • Load
  • Currents are nominal (kW ÷ V), before conversion losses.

What is an 800 VDC data center?

Today's AI hall moves power through seven conversion stages: utility medium voltage, a transformer to 415 or 480 VAC, a double-conversion UPS, PDUs and busway, in-rack shelves that rectify 415 VAC to 54 VDC, a 54 V busbar, and tray regulators to below 1 V. SemiAnalysis measures that chain at 82.0% end to end (SemiAnalysis, May 2026).

An 800 VDC data center rectifies AC to 800 VDC once, in a rack-adjacent power rack now and in facility rectifiers or solid-state transformers (SSTs) later, then runs DC busway to racks whose converters step 800 V straight to 12 V beside the GPU. SemiAnalysis puts that chain at 87.4%, in line with NVIDIA's claims of "up to 5%" better end-to-end efficiency and 45% less copper than 415 VAC (NVIDIA, May 2025); McKinsey estimates 40–50% less copper (McKinsey, Jul 2026).

A version note: NVIDIA's May 2025 post said "85% more power through the same conductor size"; its October 2025 whitepaper says 157% more than 415 VAC, 1.7 versus 0.6 kW per mm² (NVIDIA whitepaper, Oct 2025). We use the latter.

Why can't a 1 MW rack run on 54 volts?

Current. At a fixed voltage, amps scale with rack power. A 600 kW rack at 800 V draws about 750 A; at 48–54 V it would draw roughly 11,100–12,500 A (SemiAnalysis), and copper, connectors and resistive loss scale with it. NVIDIA's arithmetic for a 1 MW rack at 54 V is "up to 200 kg of copper busbar" and "up to 64 U" of power shelves, and "as racks exceed 200 kW, this approach begins to hit physical limits" (NVIDIA, May 2025).

The racks are past that line. GB200 NVL72 draws 132 kW with 192 kW of busway provisioned (HPE, Sep 2026); Kyber is specified at 600 kW (DCD, Mar 2025); and NVIDIA targets "1 MW racks starting 2027" (NVIDIA, May 2025).

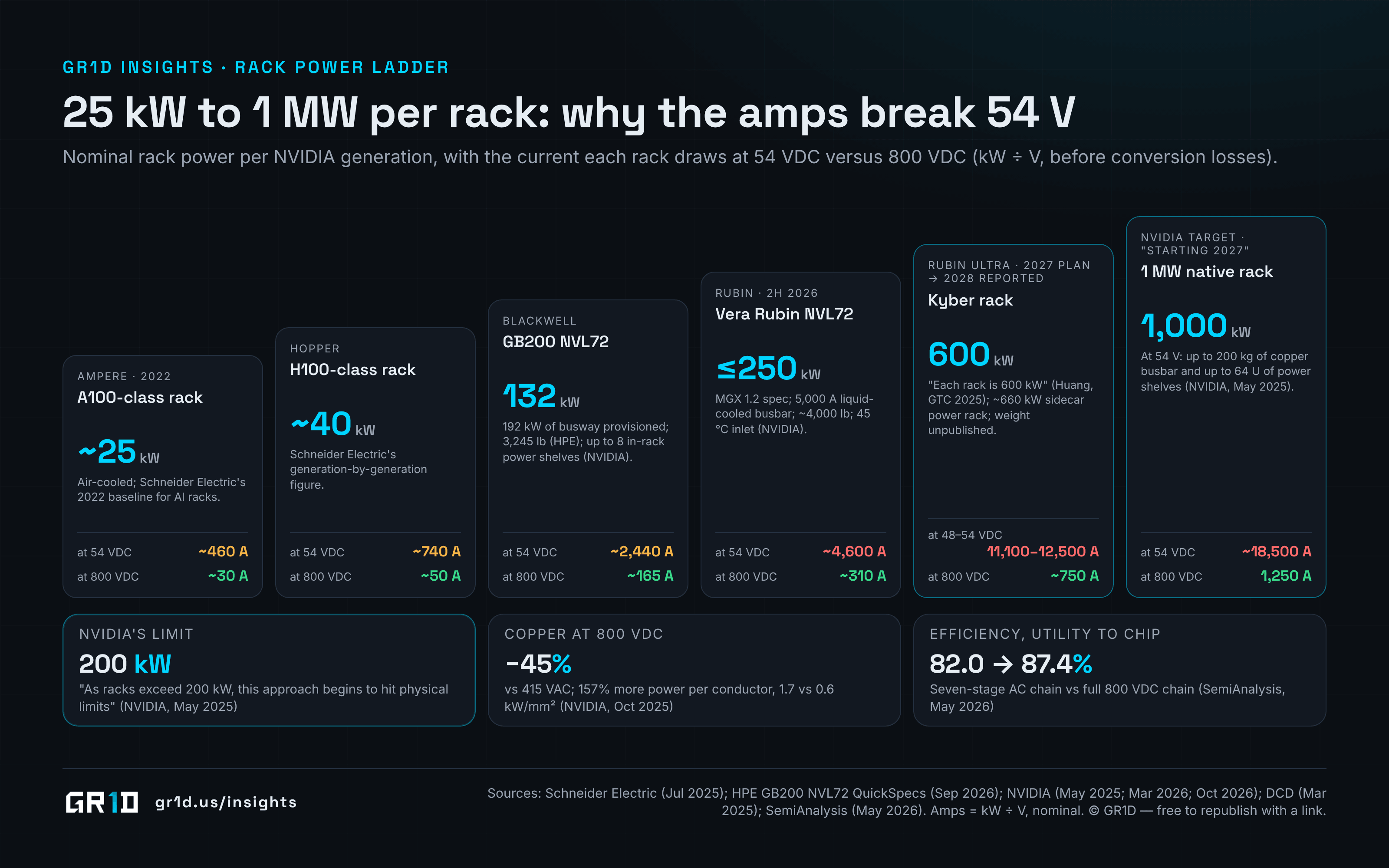

Rack power ladder from about 25 kW for A100-class racks and 40 kW for H100 to 132 kW for GB200 NVL72, up to 250 kW for Vera Rubin NVL72 in 2026, 600 kW for the Kyber rack and 1 MW native racks, with current at 54 VDC rising from roughly 460 A to 18,500 A while current at 800 VDC stays between about 30 A and 1,250 A.
Rack power from 25 kW to 1 MW and the current each rack draws at 54 VDC versus 800 VDC. Sources: Schneider Electric Jul 2025; HPE Sep 2026; NVIDIA May 2025 and Mar 2026; DCD Mar 2025; SemiAnalysis May 2026. © GR1DFull size ↗
Read as text
  • 25 kW to 1 MW per rack: why the amps break 54 V
  • Nominal rack power per NVIDIA generation, with the current each rack draws at 54 VDC versus 800 VDC (kW ÷ V, before conversion losses).
  • AMPERE · 2022
  • A100-class rack
  • ~25kW
  • kW
  • Air-cooled; Schneider Electric's 2022 baseline for AI racks.
  • at 54 VDC · ~460 A
  • at 54 VDC
  • ~460 A
  • at 800 VDC · ~30 A
  • at 800 VDC
  • ~30 A
  • HOPPER
  • H100-class rack
  • ~40kW
  • Schneider Electric's generation-by-generation figure.
  • at 54 VDC · ~740 A
  • ~740 A
  • at 800 VDC · ~50 A
  • ~50 A
  • BLACKWELL
  • GB200 NVL72
  • 132kW
  • 192 kW of busway provisioned; 3,245 lb (HPE); up to 8 in-rack power shelves (NVIDIA).
  • at 54 VDC · ~2,440 A
  • ~2,440 A
  • at 800 VDC · ~165 A
  • ~165 A
  • RUBIN · 2H 2026
  • Vera Rubin NVL72
  • ≤250kW
  • MGX 1.2 spec; 5,000 A liquid-cooled busbar; ~4,000 lb; 45 °C inlet (NVIDIA).
  • at 54 VDC · ~4,600 A
  • ~4,600 A
  • at 800 VDC · ~310 A
  • ~310 A
  • RUBIN ULTRA · 2027 PLAN → 2028 REPORTED
  • Kyber rack
  • 600kW
  • "Each rack is 600 kW" (Huang, GTC 2025); ~660 kW sidecar power rack; weight unpublished.
  • at 48–54 VDC · 11,100–12,500 A
  • at 48–54 VDC
  • 11,100–12,500 A
  • at 800 VDC · ~750 A
  • ~750 A
  • NVIDIA TARGET · "STARTING 2027"
  • 1 MW native rack
  • 1,000kW
  • At 54 V: up to 200 kg of copper busbar and up to 64 U of power shelves (NVIDIA, May 2025).
  • at 54 VDC · ~18,500 A
  • ~18,500 A
  • at 800 VDC · 1,250 A
  • 1,250 A
  • NVIDIA'S LIMIT · 200 kW · "As racks exceed 200 kW, this approach begins to hit physical limits" (NVIDIA, May 2025)
  • COPPER AT 800 VDC · −45% · vs 415 VAC; 157% more power per conductor, 1.7 vs 0.6 kW/mm² (NVIDIA, Oct 2025)
  • EFFICIENCY, UTILITY TO CHIP · 82.0 → 87.4% · Seven-stage AC chain vs full 800 VDC chain (SemiAnalysis, May 2026)

What are NVIDIA's three deployment options, and when do they ship?

NVIDIA's second whitepaper sets out three steps (NVIDIA whitepaper v2, 2026).

Source: NVIDIA 800 VDC whitepaper v2 (2026). No third-party 800 VDC pilot is publicly operating as of October 14, 2026.
StepWhat it isRatingUpstream changeNVIDIA's date
Power Rack (sidecar)Rack-adjacent rectifier: 12 × 100 A AC whips in, 125 A DC out; six 18.3 kW PSU shelves; 80 kW battery for 60 s~660 kWNone; installs "without modification to upstream AC electrical rooms"Production Q3 2026
Power Center (row)Row rectifier and storage feeding DC buswayUp to 2 MWLV gear starts to shrinkPilots "as soon as Q3 2027"
DC Power Block, then MV SSTFour 1.6 MW centers (4-to-make-3); later MV SSTs fed at 34.5 kV~4.8 MW; SSTs ~10 MWLV transformers, UPS and PDUs goLong term; SSTs "toward 2029"

What changes at the rack with Vera Rubin NVL72 in 2026?

Vera Rubin NVL72 straddles the transition: a low-voltage busbar inside the rack, fed by AC power shelves or, through a sidecar, by 800 VDC. NVIDIA's March 2026 numbers: roughly 4,000 lb, 45 °C inlet water, a 5,000 A liquid-cooled busbar and six times Blackwell's rack-level energy storage (400 J per GPU), cutting peak current by up to 25% (NVIDIA, Mar 2026). The MGX 1.2 specification open-sourced on October 12, 2026 allows up to 250 kW per rack (NVIDIA, Oct 2026).

The floor is the developer's number. A 1,500 kg GB200 NVL72 compute rack already loads it at roughly 1,875 kg/m² against a typical 1,000 kg/m² raised-floor rating (Introl, citing NVIDIA's deployment guide), and Vera Rubin is about a fifth heavier.

When does the 600 kW Kyber rack arrive?

Jensen Huang introduced Kyber at GTC 2025 as the Rubin Ultra NVL576 rack, "Each rack is 600 kW, 2.5 million parts," for 2H 2027 (DCD, Mar 18, 2025). The GTC 2026 roadmap kept Kyber for 2027 as an NVL144 system, with Feynman in 2028 (DCD, Mar 20, 2026). On July 6, 2026 SemiAnalysis reported that Kyber had slipped to 2028 over midplane manufacturability and that Rubin Ultra had been cut to two dies; NVIDIA did not comment (SDxCentral, Jul 2026). Kyber's weight is unpublished, and we do not use the "1.4 MW rack" figure seen in some coverage; no primary source supports it.

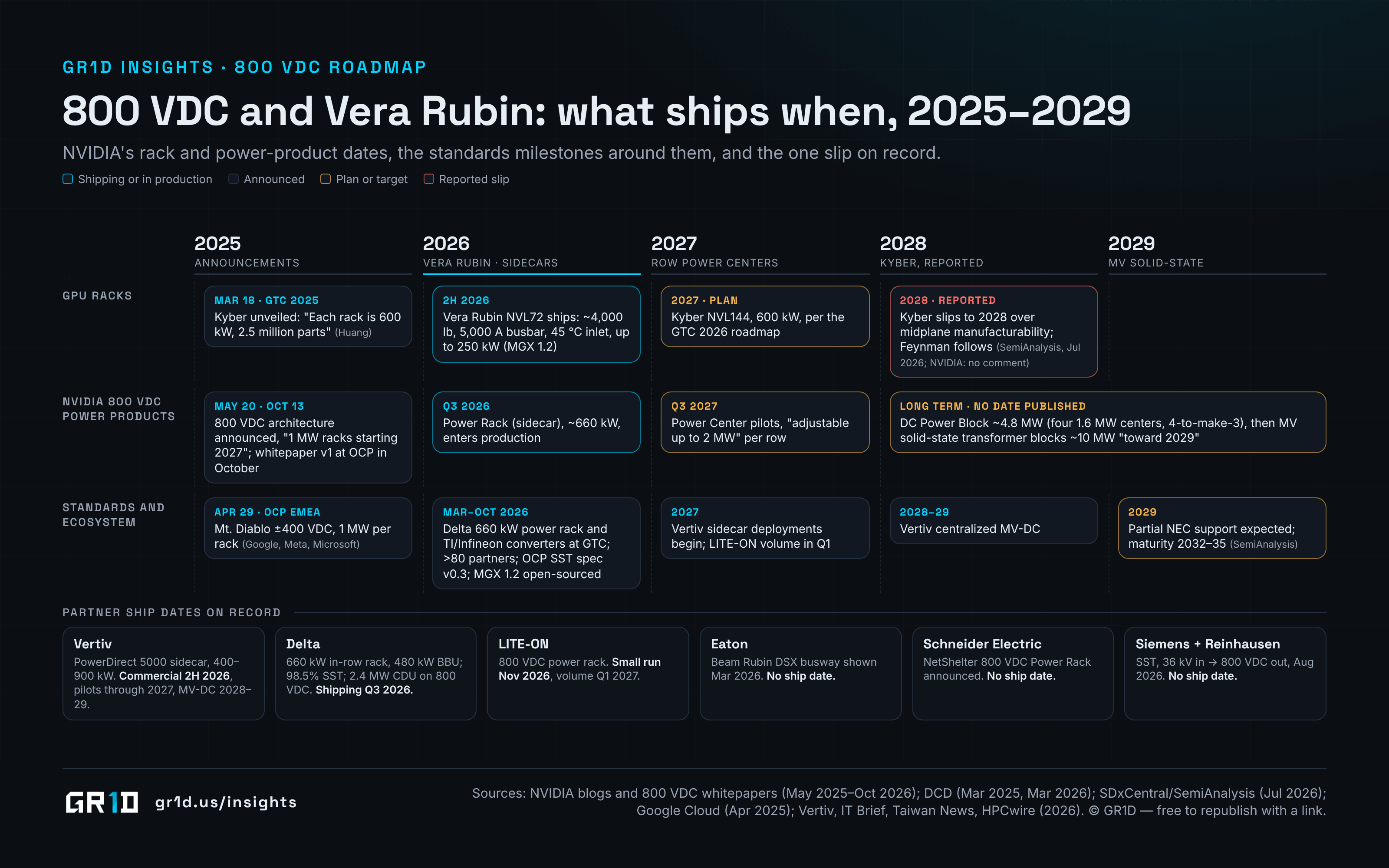

Timeline from 2025 to 2029: Mt. Diablo ±400 VDC and NVIDIA's 800 VDC announcement in 2025; Vera Rubin NVL72 and the ~660 kW Power Rack in 2026; Power Center pilots up to 2 MW and the planned 600 kW Kyber rack in 2027 with a reported slip to 2028; 4.8 MW DC Power Blocks and ~10 MW medium-voltage solid-state transformer blocks toward 2029; with Vertiv, Delta, LITE-ON, Eaton, Schneider Electric and Siemens ship dates beneath.
800 VDC and Vera Rubin: what ships when, 2025–2029. Sources: NVIDIA May 2025, Oct 2025, Mar–Oct 2026 and whitepaper v2; DCD Mar 2025 and Mar 2026; SDxCentral/SemiAnalysis Jul 2026; Google Cloud Apr 2025; Vertiv 2026; IT Brief Mar 2026; Taiwan News Aug 2026; HPCwire Aug 2026. © GR1DFull size ↗
Read as text
  • 800 VDC and Vera Rubin: what ships when, 2025–2029
  • NVIDIA's rack and power-product dates, the standards milestones around them, and the one slip on record.
  • Shipping or in production
  • Announced
  • Plan or target
  • Reported slip
  • 2025 · ANNOUNCEMENTS
  • ANNOUNCEMENTS
  • 2026 · VERA RUBIN · SIDECARS
  • VERA RUBIN · SIDECARS
  • 2027 · ROW POWER CENTERS
  • ROW POWER CENTERS
  • 2028 · KYBER, REPORTED
  • KYBER, REPORTED
  • 2029 · MV SOLID-STATE
  • MV SOLID-STATE
  • GPU RACKS
  • MAR 18 · GTC 2025 · Kyber unveiled: "Each rack is 600 kW, 2.5 million parts" (Huang)
  • 2H 2026 · Vera Rubin NVL72 ships: ~4,000 lb, 5,000 A busbar, 45 °C inlet, up to 250 kW (MGX 1.2)
  • 2027 · PLAN · Kyber NVL144, 600 kW, per the GTC 2026 roadmap
  • 2028 · REPORTED · Kyber slips to 2028 over midplane manufacturability; Feynman follows (SemiAnalysis, Jul 2026; NVIDIA: no comment)
  • NVIDIA 800 VDC POWER PRODUCTS
  • MAY 20 · OCT 13 · 800 VDC architecture announced, "1 MW racks starting 2027"; whitepaper v1 at OCP in October
  • Q3 2026 · Power Rack (sidecar), ~660 kW, enters production
  • Q3 2027 · Power Center pilots, "adjustable up to 2 MW" per row
  • LONG TERM · NO DATE PUBLISHED · DC Power Block ~4.8 MW (four 1.6 MW centers, 4-to-make-3), then MV solid-state transformer blocks ~10 MW "toward 2029"
  • STANDARDS AND ECOSYSTEM
  • APR 29 · OCP EMEA · Mt. Diablo ±400 VDC, 1 MW per rack (Google, Meta, Microsoft)
  • MAR–OCT 2026 · Delta 660 kW power rack and TI/Infineon converters at GTC; >80 partners; OCP SST spec v0.3; MGX 1.2 open-sourced
  • 2027 · Vertiv sidecar deployments begin; LITE-ON volume in Q1
  • 2028–29 · Vertiv centralized MV-DC
  • 2029 · Partial NEC support expected; maturity 2032–35 (SemiAnalysis)
  • PARTNER SHIP DATES ON RECORD
  • Vertiv
  • PowerDirect 5000 sidecar, 400–900 kW. Commercial 2H 2026, pilots through 2027, MV-DC 2028–29.
  • Commercial 2H 2026
  • Delta
  • 660 kW in-row rack, 480 kW BBU; 98.5% SST; 2.4 MW CDU on 800 VDC. Shipping Q3 2026.
  • Shipping Q3 2026.
  • LITE-ON
  • 800 VDC power rack. Small run Nov 2026, volume Q1 2027.
  • Small run Nov 2026
  • Eaton
  • Beam Rubin DSX busway shown Mar 2026. No ship date.
  • No ship date.
  • Schneider Electric
  • NetShelter 800 VDC Power Rack announced. No ship date.
  • Siemens + Reinhausen
  • SST, 36 kV in → 800 VDC out, Aug 2026. No ship date.

Which vendors ship 800 VDC gear, and when?

More than 80 manufacturers are building to the specification (NVIDIA, Aug 2026); published ship dates are thinner than that count suggests.

No live 800 VDC pilot has been named publicly as of October 14, 2026; Visionbay's K-1 platform with Vertiv is an announced design (NVIDIA, Oct 2026).
VendorProductPublished date
VertivPowerDirect 5000 sidecar, 400–900 kW; centralized MV-DCCommercial 2H 2026; deployments from 2027; MV-DC 2028–29 (Vertiv)
Delta660 kW in-row power rack, 480 kW BBU; 98.5% SST; 2.4 MW CDU on 800 VDC pumpsShown Mar 2026 (IT Brief); shipping Q3 2026 (Taiwan News, Aug 18, 2026)
LITE-ON800 VDC power rackSmall run Nov 2026; volume Q1 2027 (Taiwan News, Aug 18, 2026)
Siemens with ReinhausenSST, 36 kV in, 800 VDC outAnnounced Aug 2026; no ship date (HPCwire, Aug 14, 2026)
Eaton; Schneider ElectricBeam Rubin DSX busway (Mar 2026); NetShelter 800 VDC Power RackNo published ship dates

Unipolar 800 V or ±400 V: which standard wins?

NVIDIA chose unipolar 800 V because two-pole breakers for it exist and bipolar protective devices do not (NVIDIA whitepaper v2). The Mt. Diablo specification from Google, Meta and Microsoft, published in April 2025, uses ±400 VDC for 1 MW racks to "leverage the supply chain established by electric vehicles" (Google Cloud, Apr 2025). In August 2026 NVIDIA reported alignment with Google and Microsoft, and a native-800 V Mt. Diablo 2.0 is "coming later," without a date (NVIDIA, Aug 2026). The shell items below serve both camps; where they diverge (busway, breakers, grounding), let the tenant buy and avoid a mixed campus.

Legal, and less settled than legal sounds. NEC 2026 moved systems above 1,500 VDC into new Articles 265–270, so 800 VDC stays low voltage, and revised 110.16 labels must state voltage, boundary, incident energy and date (Conductor Wire, Mar 2026). Engineering commentary maps the applicable articles as 645, 712 (DC microgrids), 240 and 110; NFPA 855 attaches once batteries sit on the DC bus (Jason Agee, May 2026).

Arc flash is the practical gap: there is no IEEE 1584 method for DC, so engineers fall back on NFPA 70E Annex D (Agee). Schneider Electric's August 2026 sidecar study found incident energy below 1.2 cal/cm², because capacitor discharge dominates the fault (Schneider Electric, Aug 20, 2026). Grounding, whether high-resistance, floating or solid, is still an open choice (NVIDIA whitepaper v2).

Listings lag. UL Solutions leads OCP's codes-and-standards workstream after a gap analysis of more than 60 standards (UL Solutions, Oct 2026); UL 857 Edition 14 raised DC busway to 1,000 VDC (DCD, Feb 2026); no UL-certified data-center SST existed as of May 2026, and SemiAnalysis expects partial NEC support in 2029 (SemiAnalysis). In Jason Agee's words, "an unfavorable insurance position can stop a project as effectively as a permit denial."

What changes in the building, room by room?

Phase 1 "deletes nothing": the sidecar sits in white space, the UPS and switchgear stay, and non-IT loads stay on AC (SemiAnalysis).

Sources: SemiAnalysis May 2026; NVIDIA whitepapers Oct 2025 and 2026; DCD Feb 2026 (UL 857).
RoomSidecar phase, 2026–27Native 800 VDC, 2028 on
MV yard and interconnectUnchangedUnchanged; MV rectifiers accept 34.5 kV
LV electrical roomsUnchanged; AC feeds the power racksTransformers, UPS and PDUs shrink or go
Grey spaceNothing addedPads and conduit for SST skids to 7.5 MVA; BESS pad with NFPA 855 setbacks
BuswayAC to sidecars, 12 × 100 A whips each6,000 A busduct, 1,250 A row busway, 125 A taps; UL 857 Ed. 14 listing
White space and floorOne sidecar per compute rack; slab for ~4,000 lb racksRow power centers to 2 MW; Kyber footprint and weight unpublished
Safety and commissioningNFPA 855 for batteries; DC PPE, lockout, interlock testsPlus BESS, insulation-monitor baselining, millisecond protection coordination

The schedule driver does not change: large power transformers still average about 128 weeks (Wood Mackenzie, Oct 2025), and the sequence in How a Data Center Is Built still applies.

What does 800 VDC cost per MW?

Two numbers that look contradictory are both right. McKinsey estimates that native 800 VDC cuts non-IT capex 15–18%, saves $4–8 million per 10 MW and trims power opex 8–10% (McKinsey, Jul 2026). SemiAnalysis estimates that the sidecar phase adds about $400–500k per MW, because an 800 VDC power rack costs roughly ten times an AC power rack and nothing upstream is removed, within total electrical content of $3.6–4.8 million per MW (SemiAnalysis). The saving arrives with the row and facility phases; the premium arrives first.

How does ERCOT treat 800 VDC loads?

NVIDIA describes AI halls as "hundreds of megawatts ramping up and down in seconds" (NVIDIA, Oct 2025), so 800 VDC is also a storage architecture: capacitors for events under 100 ms, hybrid storage to 10 s, batteries beyond that and a BESS at the interconnect (NVIDIA whitepaper, Oct 2025). OCP's Grid Resilience specification targets a return to near-full load within 2 s of a grid event (NVIDIA, Oct 2026).

IEEE Spectrum reported in July 2026 that ERCOT's Large Load Working Group is evaluating 800 VDC designs, that ERCOT had logged 438 GW of large-load requests, and that the PUC approved ERCOT's large-load proposal with ride-through and load-smoothing provisions (IEEE Spectrum, Jul 2026). Storage that flattens a hall's draw is what those provisions reward, including at the sub-75 MW sites in Small, Bespoke AI Data Centers.

What should an 800 VDC-ready shell include today?

Nine items, none requiring DC equipment before a tenant asks:

  1. MV yard and 34.5 or 13.8 kV gear sized for 2 MW rows and 4.8 MW blocks.
  2. Grey-space pad and conduit for rectifier or SST skids.
  3. Structure for two-tonne racks plus one sidecar position each.
  4. 45 °C warm-water loop and CDU space in 2.4 MW increments.
  5. Hangers and routing for 1,250 A DC busway.
  6. Grounding grid that can run high-resistance grounded.
  7. BESS pad with NFPA 855 setbacks.
  8. AHJ pre-application with a compliance map (NEC 645, 712; NFPA 855, 70E).
  9. DC-trained O&M and PPE program before the first sidecar lands.

What could still go wrong?

  • Standards. Grounding "becomes a vendor-ecosystem commitment" and maturity is a 2032–35 event (SemiAnalysis); unipolar 800 V and ±400 V are not interchangeable at the busway, and Mt. Diablo 2.0 has no date (NVIDIA, Aug 2026).
  • Serviceability. Distributed batteries and capacitors are harder to run than one central UPS, and stored DC energy at the rack defeats AC lockout habits.
  • Delivery. Kyber has reportedly moved to 2028, and Vertiv now says sidecar deployments "begin in 2027" (Vertiv). Plan the shell for it; do not plan the lease start around it.

Frequently asked questions

What is an 800 VDC data center?

A facility that rectifies utility AC to 800 volts DC once, in a sidecar power rack, a row power center or a facility rectifier, and distributes DC to racks whose converters step 800 V straight to 12 V beside the GPU.

When will 800 VDC be needed?

Sidecar power racks enter production in Q3 2026 alongside Vera Rubin NVL72, which still accepts AC. Native 800 VDC becomes necessary at Kyber-class 600 kW racks, planned for 2027 and reportedly slipping to 2028, and at the 1 MW racks NVIDIA targets from 2027.

Can an existing AC data center be retrofitted for 800 VDC?

For the first phase, yes: NVIDIA's power rack installs "without modification to upstream AC electrical rooms" and feeds 800 VDC to adjacent racks. Native 800 VDC needs new distribution: SST skids, DC busway, DC-rated protection and a grounding scheme.

Is 800 VDC legal under the NEC?

Yes. NEC 2026 keeps systems below 1,500 VDC in the low-voltage articles, and NFPA 855 attaches once batteries sit on the bus. Listings, a DC arc-flash method and trained workers lag, so engage the AHJ and the insurer early.

Does 800 VDC change the utility interconnect or generators?

No. Medium-voltage rectifiers take 34.5 kV utility distribution, so the substation, interconnection agreement and generators stay as designed. What is added is energy storage on the DC bus and ride-through controls, which is what ERCOT's load-smoothing provisions reward.

How much power does a Vera Rubin rack use?

NVIDIA's MGX 1.2 specification allows up to 250 kW per Vera Rubin NVL72 rack on a 5,000 A liquid-cooled busbar at 45 °C inlet; the whitepaper v2 lists a 330 kW Gen-2 capability with AC or DC input. The rack weighs roughly 4,000 lb and ships in 2H 2026.

Sources

  1. NVIDIA 800 V HVDC Architecture Will Power the Next Generation of AI Factories — NVIDIA Developer Blog, 2025-05-20
  2. Building the 800 VDC Ecosystem for Efficient, Scalable AI Factories — NVIDIA Developer Blog, 2025-10-13
  3. 800 VDC Architecture for Next-Generation AI Infrastructure (whitepaper) — NVIDIA, 2025-10
  4. 800 VDC Architecture whitepaper v2 — NVIDIA, 2026
  5. NVIDIA Vera Rubin POD: Seven Chips, Five Rack-Scale Systems, One AI Supercomputer — NVIDIA Developer Blog, 2026-03-16
  6. 800 VDC power architecture for the AI factory: ecosystem update — NVIDIA Blog, 2026-08-11
  7. OCP Global Summit: Vera Rubin and scale AI factories — NVIDIA Blog, 2026-10-12
  8. Inside the 800 VDC Revolution — SemiAnalysis, 2026-05-26
  9. The shift to 800-volt DC at data centers: implications for providers — McKinsey, 2026-07-30
  10. 800 VDC for data centers — IEEE Spectrum, 2026-07-16
  11. Enabling 1 MW IT racks and liquid cooling at OCP EMEA Summit — Google Cloud, 2025-04-29
  12. NVIDIA's Rubin Ultra NVL576 rack expected to be 600 kW, coming second half of 2027 — Data Center Dynamics, 2025-03-18
  13. NVIDIA updates data center product roadmap following LPU launch at GTC 2026 — Data Center Dynamics, 2026-03-20
  14. NVIDIA pushes Kyber release to 2028 following manufacturing concerns: report — SDxCentral, 2026-07-06
  15. Delta unveils 800 VDC power and cooling for AI data centres — IT Brief Australia, 2026-03-17
  16. From rack to data hall: the practical path to 800 VDC — Vertiv, 2026
  17. NEC 2026: the new rules for data center power — Conductor Wire, 2026-03-23
  18. Powering the AI boom without losing sight of electrical safety — UL Solutions, 2026-10-07
  19. GB200 NVL72 deployment: 72 GPUs, liquid cooled — Introl, n.d.
  20. AI data center design and deployment are moving at an incredible pace — Schneider Electric, 2025-07-23
  21. HPE NVIDIA GB200 NVL72 QuickSpecs — HPE, 2026-09-08
  22. Mind the gap: tackling supply chain challenges in the electric T&D sector — Wood Mackenzie, 2025-10-15
  23. Batch Zero Update — ERCOT, 2026-09-11
  24. Texas Large Load Interconnection Update: ERCOT Batch Zero Pause and Verification Process — Baker Botts, 2026-08
  25. PUCT sets financial commitments for data center interconnection; Governor pauses permits — White & Case, 2026-09-25
  26. Texas pauses all environmental permitting for data centers — Beveridge & Diamond, 2026-09-29
  27. Taiwan power suppliers prepare for Nvidia's 800VDC architecture — Taiwan News, 2026-08-18
  28. Siemens and Reinhausen develop direct-current power solutions for AI data centers — HPCwire, 2026-08-14
  29. Code compatibility of 800 volt direct current in data centers — Jason Agee, 2026-05-07
  30. Why arc flash safety analysis is critical to the industry's shift to 800 VDC in AI data centers — Schneider Electric, 2026-08-20
  31. Why standards must keep pace with rising data center voltages — Data Center Dynamics, 2026-02
Jamieson Hill
Founder, GR1D

Jamieson Hill is the founder of GR1D, a Texas developer of powered-shell and turnkey AI data centers. He leads site acquisition, power procurement, joint-venture structuring and vendor negotiation across GR1D's 20 MW to 370 MW pipeline in South Houston, East Austin and North Texas.
